De-identified reference example showcasing end-to-end process optimization, interface waste elimination, and measurable operational improvements.
Prepared by Jake and the JETi Team
Representative Example (De-identified) - No Client-Specific Information
Ranked improvement opportunities at interface points where waste accumulates. Each burst identifies root cause, countermeasure, ownership, and measurable outcomes.
| ID | WASTE TYPE | INTERFACE | ROOT CAUSE | COUNTERMEASURE | OWNER ROLE | EFFORT | IMPACT | EXPECTED OUTCOME | TIMELINE |
|---|---|---|---|---|---|---|---|---|---|
| KB-01 | Waiting | Engineering ↔ Procurement | BOM changes after procurement starts; no formal freeze gate | Implement BOM freeze gate at 95% design completion with change control board | Engineering Manager | M | L | Reduce procurement queue time 60% (120h → 48h) | 30/60/90 |
| KB-02 | Defects | Procurement ↔ Factory | Material shortages and substitutions not communicated; no kitting process | Establish material supermarket with visual kanban and pre-kitting station | Supply Chain Lead | L | L | Increase factory FPY from 85% to 92%; reduce WIP 50% | 60/90/120 |
| KB-03 | Overprocessing | Factory ↔ QC | Unclear acceptance criteria; inspection checklist varies by inspector | Standardize QC checklist with visual work instructions and go/no-go gauges | Quality Manager | S | M | Reduce rework loops 40%; cut QC cycle time from 180min to 120min | 30/60 |
| KB-04 | Waiting | Staging ↔ Logistics | Carrier scheduling ad-hoc; no advance notice to staging team | Implement 72-hour logistics scheduling cadence with staging team sync | Logistics Coordinator | S | M | Reduce staging queue time 67% (36h → 12h); eliminate rush loadouts | 30 |
| KB-05 | Transport | Logistics ↔ Site | Site readiness unknown; crane/access constraints discovered on arrival | Deploy site readiness checklist 2 weeks pre-delivery with photo verification | Site Manager | S | L | Eliminate 80% of delivery delays; reduce logistics queue 75% (96h → 24h) | 30/60 |
| KB-06 | Defects | Set/Install ↔ Punchlist | Handoff gaps between install crew and punchlist team; no formal walkthrough | Require joint walkthrough with photo documentation before crew demobilization | Installation Supervisor | S | M | Reduce punchlist rework 60% (25% → 10%); cut closeout time 40% | 30 |
| KB-07 | Inventory | Factory Fabrication | Batch size of 2 units creates excess WIP; no pull signal from downstream | Reduce batch to 1 unit (single-piece flow) with WIP cap of 2 between stations | Production Manager | M | L | Cut lead time 30%; reduce WIP from 6 to 2 units; improve cash flow | 60/90 |
| KB-08 | Underutilized Talent | Engineering/Procurement Interface | Procurement team not involved in design reviews; late-stage supplier input | Add procurement rep to weekly design review with supplier feedback loop | Chief Engineer | S | M | Reduce BOM changes 50%; improve material availability 30% | 30 |
| KB-09 | Motion | QC/Inspection | Inspection tools and documentation scattered; inspector walks 200ft per unit | Create QC workstation with all tools, gauges, and digital checklists at point of use | Quality Manager | M | S | Reduce QC cycle time 20%; improve inspector ergonomics | 60 |
| KB-10 | Waiting | Design/Engineering | Design reviews scheduled monthly; bottleneck for fast-track projects | Shift to weekly design review cadence with fast-track slot for urgent items | Engineering Manager | S | M | Reduce engineering queue time 67% (72h → 24h); improve schedule predictability | 30 |
Modular home manufacturing guide for leaders. Practical tools for identifying interface failures, conducting gemba walks, and establishing operational cadence.
EXAMPLE: Engineering completes design but procurement learns of critical spec changes via informal email
GOOD LOOKS LIKE: Formal handoff meeting with signed checklist; all changes logged in shared system
EXAMPLE: QC rejects units that factory believed met spec; no documented go/no-go standards
GOOD LOOKS LIKE: Visual work instructions with photos; measurable criteria; go/no-go gauges at workstation
EXAMPLE: Procurement orders in batches of 10; factory builds in batches of 2; excess inventory accumulates
GOOD LOOKS LIKE: Aligned batch sizes across value stream; pull signals trigger replenishment
EXAMPLE: Logistics schedules carrier without confirming staging readiness; units not loaded
GOOD LOOKS LIKE: Synchronized scheduling cadence; 72-hour advance notice; daily tier meetings
EXAMPLE: Defects discovered at QC sent back to factory with vague notes; root cause unknown
GOOD LOOKS LIKE: Structured defect reporting with photos; root cause analysis; corrective action tracking
EXAMPLE: Engineering change requests sit in inbox for days; no escalation path
GOOD LOOKS LIKE: Change control board meets weekly; 48-hour SLA for approval/rejection; escalation protocol
EXAMPLE: Factory discovers missing components mid-build; procurement unaware of urgency
GOOD LOOKS LIKE: Visual kanban system; material supermarket; automated reorder points; daily shortage huddle
EXAMPLE: Modular unit arrives on site; crane access blocked; delivery delayed 3 days
GOOD LOOKS LIKE: Site readiness checklist completed 2 weeks prior; photo verification; logistics confirmation
EXAMPLE: Install crew leaves site; punchlist team finds 30 items incomplete; warranty clock starts
GOOD LOOKS LIKE: Joint walkthrough before crew demobilization; photo documentation; sign-off protocol
EXAMPLE: Factory solves quality issue without informing engineering; root cause persists in next design
GOOD LOOKS LIKE: Cross-functional problem-solving teams; lessons learned database; design feedback loop

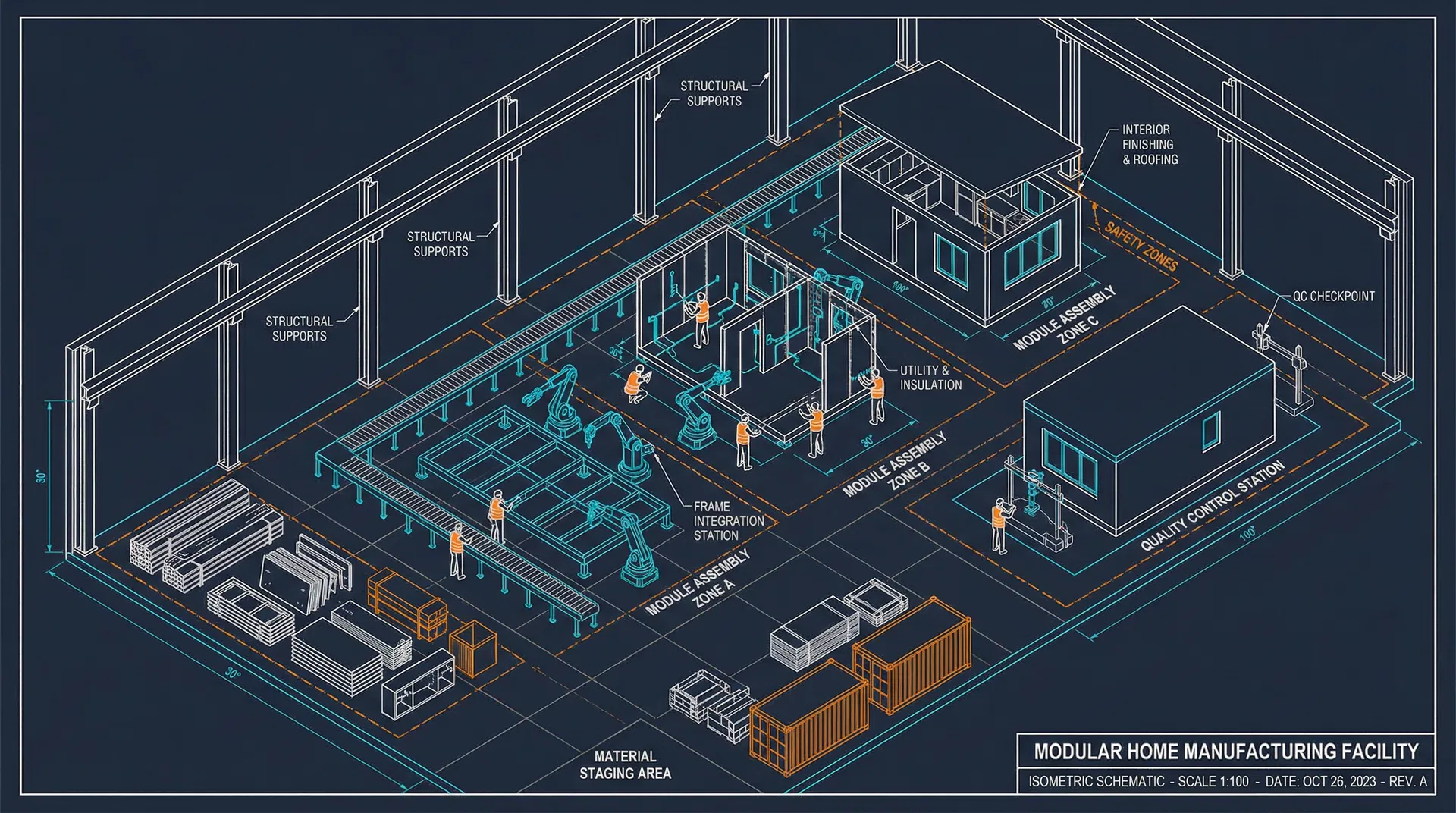

Isometric schematic showing material flow, assembly zones, quality control checkpoints, and staging areas in a representative modular construction facility.
